Overtime Isn’t Free: How to Price Lost Productivity When You’re Asked to Accelerate
RyanCo Construction | Contractor resource
The schedule slipped, and it wasn’t your fault. Maybe a utility relocation ran late, or the agency took three rounds to approve a submittal. Now the GC wants the pipe crew on 6-10s for the next six weeks to get back on track. You send a change order for the overtime premium, it gets approved, and everyone moves on.
Six weeks later the crew has worked 50 percent more hours, but the footage didn’t go up anywhere near 50 percent. The premium you were paid covers the extra wage rate. It doesn’t cover the hours that went into fatigue, longer days and a crew running at the edge. That gap is loss of productivity, and on a long acceleration it can cost more than the premium itself.
This article covers how to estimate it with the most widely cited overtime data, how to keep the math consistent, when the method doesn’t fit, and what to put in writing before the first long week starts. It’s practical guidance for estimators and PMs, not legal advice. Your contract and your own counsel control.
What the productivity index actually means
Overtime studies express their results as a productivity index, or PI. In plain terms, the PI is the share of a normal hour’s work you get out of each hour worked on the overtime schedule.
A PI of 0.85 means each hour on that schedule produces about 85 percent of what a straight-time hour would have. The definition used in the MCAA bulletin is planned hours per unit divided by actual hours per unit, so a PI of 1.0 means no loss and anything below 1.0 means the work took more hours than planned.
Two details matter more than most people expect:
- The PI applies to every hour the crew works on that schedule, not just the overtime hours. A tired crew is tired at 7 a.m. on Thursday, too. The MCAA bulletin says its inefficiency percentages are to be applied to all hours worked by a crew on an overtime schedule.
- The loss builds week over week. One long week costs little. The sixth consecutive long week costs a lot. According to the bulletin, returning to a normal 40-hour schedule tends to reset the crew, so a crew that goes back to overtime after a week or two at 40 hours starts over at the week 1 value.
Where the numbers come from
The reference most contractors use is the Mechanical Contractors Association of America’s Bulletin No. OT1 Revised (2011), How to Estimate the Impacts of Overtime on Labor Productivity. MCAA didn’t run a new study for it. The bulletin compares and averages four existing ones:
- Business Roundtable (BRT), Schedule Overtime Effects on Construction Projects, 1980
- National Electrical Contractors Association (NECA), Overtime and Productivity in Electrical Construction, 1989
- H. Randolph Thomas and others at Penn State, Schedule Overtime and Labor Productivity: Quantitative Analysis, 1997
- U.S. Army Corps of Engineers, Modification Impact Analysis Guide, 1979
Not every study covers every schedule. The 50-hour column draws on all four. The 84-hour column (7-12s) comes from NECA alone, because the other studies didn’t evaluate a week that long, and weeks 13 through 16 come only from NECA as well. Where NECA published low, average and high curves, MCAA used the average values.
Here is the bulletin’s summary table:

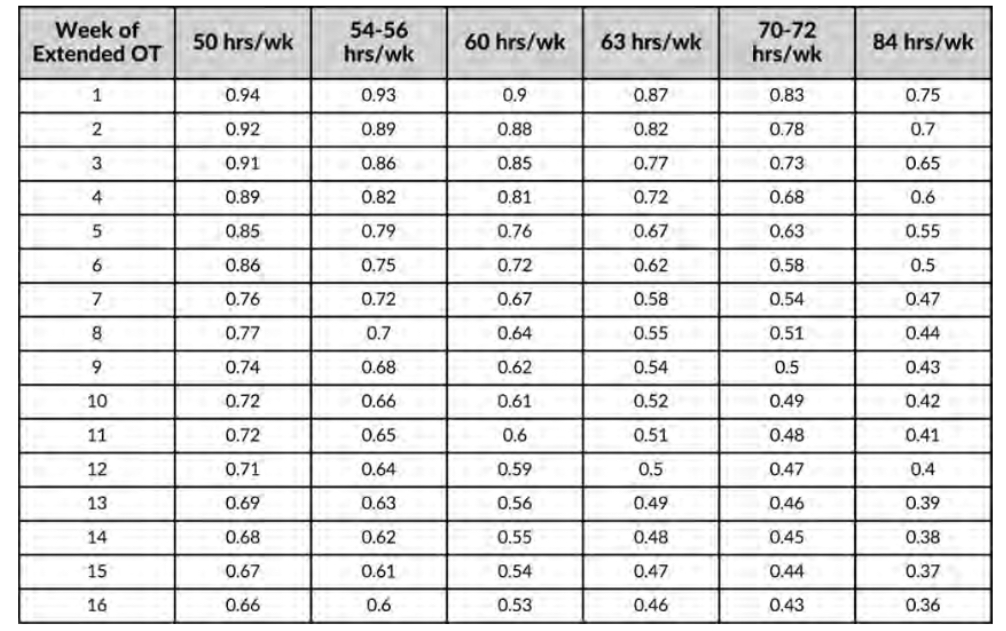

Productivity index by weekly hours and consecutive week of extended overtime (MCAA Bulletin OT1 Revised, 2011). Source: Long International’s reprint of MCAA Bulletin OT1 Revised (2011)
| Week of extended OT | 50 hrs/wk | 54 to 56 hrs/wk | 60 hrs/wk | 63 hrs/wk | 70 to 72 hrs/wk | 84 hrs/wk |
|---|---|---|---|---|---|---|
| 1 | 0.95 | 0.94 | 0.91 | 0.89 | 0.86 | 0.75 |
| 2 | 0.93 | 0.90 | 0.88 | 0.84 | 0.80 | 0.70 |
| 3 | 0.92 | 0.86 | 0.85 | 0.78 | 0.73 | 0.65 |
| 4 | 0.91 | 0.83 | 0.81 | 0.73 | 0.68 | 0.60 |
| 5 | 0.85 | 0.79 | 0.76 | 0.67 | 0.63 | 0.55 |
| 6 | 0.86 | 0.75 | 0.72 | 0.62 | 0.58 | 0.50 |
| 7 | 0.76 | 0.72 | 0.67 | 0.58 | 0.54 | 0.47 |
| 8 | 0.77 | 0.70 | 0.64 | 0.55 | 0.51 | 0.44 |
| 9 | 0.74 | 0.68 | 0.62 | 0.54 | 0.50 | 0.43 |
| 10 | 0.72 | 0.66 | 0.61 | 0.52 | 0.49 | 0.42 |
| 11 | 0.72 | 0.65 | 0.60 | 0.51 | 0.48 | 0.41 |
| 12 | 0.71 | 0.64 | 0.59 | 0.50 | 0.47 | 0.40 |
| 13 | 0.69 | 0.63 | 0.56 | 0.49 | 0.46 | 0.39 |
| 14 | 0.68 | 0.62 | 0.55 | 0.48 | 0.45 | 0.38 |
| 15 | 0.67 | 0.61 | 0.54 | 0.47 | 0.44 | 0.37 |
| 16 | 0.66 | 0.60 | 0.53 | 0.46 | 0.43 | 0.36 |
Two quirks are worth knowing before someone across the table points them out. The 50-hour column ticks up slightly in weeks 6 and 8. It’s in the values Long International reprints from the bulletin, so it isn’t a transcription error, and it’s most likely a side effect of averaging studies that report different data points. And the table was built from mechanical and electrical trade data. An underground pipe crew isn’t a mechanical crew, so expect a reviewer to ask why the factors apply to your work. A good answer is your own job data, which we’ll get to.
Chart of the 60 hrs/wk column from the table above. Click or tap to enlarge.
One convention, used both ways
A lot of LOP calculations fall apart because they mix two different formulas, one for pricing ahead of time and another for counting after the fact, and the two don’t agree. Pick one definition and stick with it. The cleanest one follows directly from what the PI means:
- Baseline-equivalent hours = hours worked on the overtime schedule x PI
- Lost hours = hours worked x (1 minus PI)
Use it forward when you price a change order before the overtime starts (you apply it to the hours you plan to work). Use it retrospectively after the work is done (you apply it to the hours your payroll actually recorded). Same formula, different hours. Label which one you’re showing every time.
If you’re starting from a quantity of work instead of a schedule, the same definition runs the other way: hours needed = baseline hours for that work divided by the PI.
One caution. The MCAA bulletin’s own retrospective example uses a slightly different formula: inefficient hours = actual hours minus actual hours divided by (1 + inefficiency). That version produces a somewhat smaller number. If your contract, your owner or a reviewer expects the bulletin’s formula, use it, but then use it consistently and say so. What gets claims picked apart is switching between the two.
A worked example, before and after
Say a six-person pipe crew was bid on a 5-8 schedule (40 hours a week) installing 8-inch PVC sewer at about 120 LF per 8-hour day, or 15 LF per crew-hour. The GC directs 6-10s (60 hours a week) for six consecutive weeks to recover a delay the sub didn’t cause. That puts us in the 60 hrs/wk column, weeks 1 through 6.
Forward estimate: six-person crew on 6-10s for six weeks (illustrative)
| Week | Crew hours worked | PI (60 hrs/wk) | Lost hours (hours x (1 minus PI)) | Expected LF per 10-hour day |
|---|---|---|---|---|
| 1 | 360 | 0.91 | 32.4 | 136.5 |
| 2 | 360 | 0.88 | 43.2 | 132.0 |
| 3 | 360 | 0.85 | 54.0 | 127.5 |
| 4 | 360 | 0.81 | 68.4 | 121.5 |
| 5 | 360 | 0.76 | 86.4 | 114.0 |
| 6 | 360 | 0.72 | 100.8 | 108.0 |
| Total | 2,160 | 385.2 |
The expected footage column is 15 LF per hour x the PI x 10 hours. Look at week 6: a 10-hour day is now expected to produce about 108 LF, less than the 120 LF the crew used to lay in an 8-hour day. Over the six weeks the crew works 2,160 hours instead of 1,440, which is 50 percent more time, but the baseline-equivalent output is 1,774.8 hours, only about 23 percent more work.
Illustrative example from the table above, not a specific project. Click or tap to enlarge.
Before (premium-only change order): the sub is paid the overtime premium on the extra hours and nothing else. The 385.2 lost crew-hours are absorbed in the sub’s margin.
After (premium plus inefficiency): the change order prices the same premium and adds 385.2 crew-hours at the applicable rates, with markup per the contract. After the work, the PM reruns the same table on recorded payroll hours. If the crew size changed or a week got rained out, the retrospective number will differ from the forward one, and that’s fine, because it reflects what actually happened.
For comparison, the bulletin’s alternate formula on the same 2,160 hours gives about 321.2 lost hours. That’s why the convention has to be stated.
Here’s why premium alone under-recovers. Say the schedule’s blended labor rate works out to 10 percent above straight time once premium hours are counted. Your real figure depends on your labor agreement, the prevailing wage determination and California’s daily overtime rules. In week 6, each unit of baseline work costs 1.10 divided by 0.72, or about 1.53 times the straight-time cost. A premium-only change order pays you 1.10.
Use your own job data when you have it
Published factors are a reasonable estimate, but they’re still someone else’s data. The stronger evidence usually comes from the job itself. A measured mile compares your productivity on a stretch of work that wasn’t affected (same crew, similar pipe, similar depth and ground) with the stretch that was. If the crew averaged 15 LF per hour on 5-8s in one reach and 11 LF per hour on 6-10s in a comparable reach, that’s harder to argue with than a table built from mechanical trades decades ago.
That only works if the records exist: daily footage, crew size and hours, depth, ground conditions, and what slowed the work. The overtime table is a good forward-pricing tool and a good cross-check. Your daily reports are what hold up a retrospective number.
When the method doesn’t apply
- Planned overtime. If the bid assumed 6-10s, the inefficiency belongs in the bid. You can’t claim it later. Shutdown work with compressed hours belongs here too: price the inefficiency up front.
- Spot overtime. A day or two of extended hours to finish a tie-in is a different situation. The bulletin notes that spot overtime isn’t normally calculated in the overtime studies, so the table isn’t built for it.
- Double counting. If you’re already claiming lost productivity for congestion, trade stacking or restricted access over the same period, adding the overtime factor on top can count the same lost hours twice. Separate the causes or use one combined measured comparison.
- No causal link. The factor estimates what overtime typically costs. It doesn’t prove the owner or GC caused it. If the delay was yours, the overtime is yours.
- Hours limits. In public right-of-way, encroachment permits and traffic control plans often restrict working hours. Before agreeing to 10-hour days, confirm the permit actually allows them. If it doesn’t, the acceleration plan may need a second shift or a weekend window instead, and that’s a different cost question. Overtime factors don’t answer it.
Night or second-shift work deserves its own basis. The OT1 table is built for extended overtime, not shift work, so don’t borrow a percentage for night work without a source you can cite.
Notice and contract language: what to do before the first long week
The way we handle this at RyanCo is simple: clarify it in writing before starting the work. We don’t surprise-bill anyone. If a directed schedule is going to cost inefficiency on top of premium pay, the GC should see that, with the basis and an estimated number, before the first 10-hour day, not on a change order after the crew has already worn down. Done that way, the inefficiency becomes part of the decision to accelerate instead of an argument afterward.
Most lost productivity money is lost on paper, not in the field. Here’s what estimators and PMs can do before the acceleration starts. None of this is legal advice, and your contract’s specific clauses come first.
- Read the notice and claim clauses. Find the deadline and the required form. On federal fixed-price construction, for example, the FAR Changes clause (52.243-4) limits recovery for a constructive change to costs incurred no more than 20 days before written notice, and requires the contractor to assert its right to an adjustment within 30 days of a written change order or notice. Subcontracts often set shorter windows than the prime contract.
- Get the directive in writing. An email from the GC’s PM telling you to go to 6-10s to recover a delay you didn’t cause is the foundation of the claim. A verbal “do what you can to catch up” is not.
- Put the inefficiency estimate in the proposal, and reserve what you can’t finalize yet. Show the forward estimate up front so nobody is surprised later. If the final number depends on how many weeks the acceleration actually runs, say so in the change order. Something like: “This change order covers overtime premium only. Labor inefficiency resulting from the directed schedule will be quantified and submitted separately.” Watch for release or “full accord and satisfaction” language in the change order you sign. It can waive the very costs you’re trying to reserve.
- Track it daily. Crew size, hours per person, footage installed, depth, conditions and interruptions. If you plan to use a measured mile, mark which reaches are unimpacted.
- Know the public works claim path. On California public works, Public Contract Code section 9204 sets a claim procedure for prime contractors: a claim sent by registered or certified mail, a public entity review and written response within 45 days, then meet-and-confer and nonbinding mediation for disputed amounts. Subcontractors without privity can ask the prime to present the claim on their behalf. SB 33 (2026) removed the section’s January 1, 2027 sunset. Caltrans projects are excluded and have their own procedures.
Questions to ask the GC before agreeing to accelerate
- Is this a directive, and will you put it in writing with the reason for the delay?
- For how many weeks, and on what schedule? (The table cares about both.)
- Will the change order cover inefficiency, or premium only? If premium only, will you accept a reservation?
- Do the encroachment permit and traffic control plan allow the extended hours?
- Can material deliveries, inspection and testing keep pace with the faster schedule, or will the crew end up waiting?
That last question matters on underground work. Accelerating the pipe crew does little if the inspector is only available eight hours a day or the backfill trucks can’t keep up.
The short version
Overtime premium pays for the higher wage rate. It doesn’t pay for the slower hours. Get the directive in writing, reserve the inefficiency, use one formula forward and back, and keep the daily records that let you prove it with your own numbers.
If you’re pricing underground water, sewer, storm drain or gas work in Southern California and want a second set of eyes on a schedule or scope, you can see what we do or get in touch.
